The additional daily intercity passenger rail round-trip will integrate with the existing Hiawatha Service schedule. The additional frequency will also facilitate existing and planned intercity bus and shuttle connections to communities located off the rail corridor.
Required railroad infrastructure improvements
- La Crosse Yard and Depot Area Improvements (La Crosse, WI) - Rebuild second mainline track, extend yard lead to the west, and reconstruct passenger platform
- Mississippi River Bridge (La Crescent, MN) - Realign track approaches, replace switches and track work
- River Junction Yard Improvements (La Crescent, MN) - Conversion of yard track to signalized 2nd main track, including signal improvements, new mainline track, turnouts, and connection track, and an upgrade to existing yard track
- Winona Siding Improvements (Winona, MN) - Upgrade siding track, switches, and signals
- Tower CK (Winona, MN) - Construct new siding track connecting main track to CPR Waseca subdivision, and add switches and signals
Project funding
- $31.8 million Federal Railroad Administration (FRA) Consolidated Railroad Infrastructure and Safety Improvement (CRISI) grant was awarded in September 2020 for final design and construction of required railroad improvements to implement TCMC passenger trains. Amtrak has committed $5 million in funding. An additional $16.2 million in state match dollars are needed:
- Wisconsin - $6.2 million
- Minnesota - $10 million
- $12.6 million Federal Railroad Administration (FRA) Restoration & Enhancement Program grant was awarded in May 2020 to offset cost of operations for the first three years.
Overview
This project began with Amtrak’s 2015 feasibility report on the proposed service. Analysis of existing passenger rail ridership on the Amtrak Empire Builder shows demand for regional transportation options.
Despite the limited schedule options, limited capacity, and challenges with on-time performance for eastbound travel on the existing Amtrak Empire Builder, more than 70% of the on/offs at Wisconsin stations are travelling to or from stations within the TCMC Corridor. The favorable ridership and revenue projections identified in the feasibility report supported a more detailed study of the proposed service.
The study's first phase evaluated alternatives for track and other infrastructure improvements required for a second round-trip, along with anticipated costs. See the Minnesota Department of Transportation's website for additional information.
To implement the additional round-trip, five rail infrastructure improvements are recommended in specific areas along the corridor. Infrastructure improvements involve:
- Communication and signaling upgrades
- Rail siding extensions
- Street-level crossing improvements
- Extending yard lead track
- New turnouts and mainline track reconstruction and modifications
The service will operate at conventional speeds of 79 miles per hour and stop at all existing stations on the Empire Builder route, plus the Milwaukee Airport Rail Station (MARS).
Location
View larger map of TCMC Service

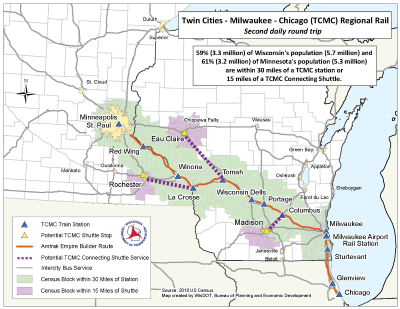

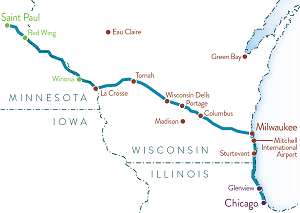

TCMC service will follow Amtrak's existing long-distance Empire Builder route between Chicago Union Station, Milwaukee Intermodal Station, and the Union Depot in St. Paul. In addition to the major metropolitan regions named above, the service connects the smaller intermediate station cities of Red Wing and Winona, Minnesota; La Crosse, Tomah, Wisconsin Dells, Portage, Columbus and Sturtevant, Wisconsin; and Glenview, Illinois. A majority of Minnesota and Wisconsin population are located within 15 miles of a proposed connecting bus shuttle stop or 30 miles of a TCMC station.
The service uses track on Amtrak's Empire Builder and Hiawatha routes, and Metra Canadian Pacific Rail (CPR), and Union Pacific (UP) right of way and tracks.
Schedule
Planning for the TCMC Service began in 2012 when project partners requested that Amtrak assess the feasibility of providing a state-supported second round-trip intercity passenger train service between the Twin Cities and Chicago Union Station. Amtrak's findings, completed in 2015, displayed favorable ridership and revenue projections which initiated more detailed study of the proposed service. Project partners continued planning activities for the TCMC Service between 2016 and 2018, including developing the purpose and need, alternatives analysis and conceptual engineering plans.
The environmental documentation was completed in 2021. The final designs are expected to be completed in 2023. Following final design, construction is anticipated to begin in 2023, with completion in 2024. The TCMC rail service is estimated to commence in 2024.
Project support
Letters and resolutions in support of the TCMC service have been received from legislators, organizations and communities from Illinois, Minnesota and Wisconsin:
Related information
Contacts
Rich Kedzior
Passenger Rail Program Manager
Railroads and Harbors Section, WisDOT
(608) 266-7094
richard.kedzior@dot.wi.gov
Greg Mathis
State Planning Director
Passenger Rail, MnDOT
(651) 366-4292
greg.mathis@state.mn.us
